Architectural Area Schedule: Reconcile Targets With the Model

Altaf Ganihar
Founder and CEO

Table of Contents

TL;DR

An architectural area schedule is a decision tool, not a decorative total. Keep target, measured, variance, status, and measurement basis visible at building, floor, department, and room-group levels. Separate net assignable space from circulation, walls, services, and other non-assignable components. When the design changes, explain the variance instead of quietly replacing the baseline.

What should an architectural area schedule contain?

At minimum, show an identifier, space or group name, target area, measured area, variance, status, and note. Add the measurement basis and model revision so the reader knows what the values mean and where they came from.

The schedule should work at more than one level. A building total can appear acceptable while one department is significantly over target and another is under. Floor, department, room group, and room-level views let the team find the real decision rather than argue about a single aggregate.

Keep the original target visible. If the brief changes, create a revised target with a decision reference instead of overwriting history. That makes it possible to distinguish design drift from an authorized program change. Without that distinction, every later variance becomes harder to explain.

Give each variance a status. Useful states might include accepted, investigate, client decision, design response, and measurement check. The labels should fit the team's process, but they need to separate a known choice from an unexplained mismatch.

Avoid excessive precision. Early design areas are estimates tied to evolving geometry. Report values at a precision that matches the model and decision. A long decimal can make a provisional boundary look more certain than it is.

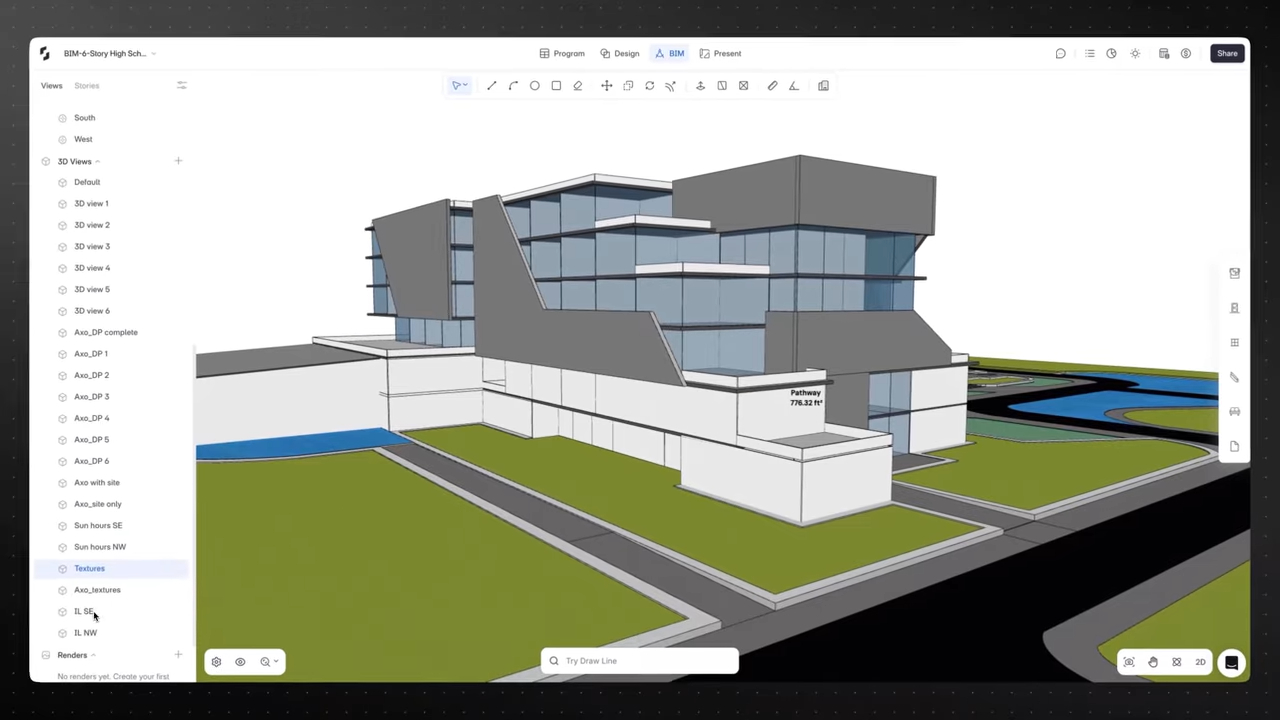

Snaptrude showing a detailed school BIM model used to reconcile area targets with the built design.

How do you define the measurement basis?

Write down what is inside the boundary. Does a room area reach the finish face, centerline, or another agreed reference? Are columns, internal partitions, balconies, shafts, stairs, and double-height voids included? Does the gross total describe one floor, the whole building, or a lease convention?

The terms net and gross are not self-explanatory. The Whole Building Design Guide distinguishes net assignable square feet from gross area and treats circulation, walls, mechanical space, toilets, and similar components as tare. It expresses building efficiency as net assignable area divided by gross area. That is a useful programming frame, but a project may have another governing standard.

International and sector-specific standards exist because measurement rules affect comparison. IPMS offers a harmonized framework across building types. BOMA maintains separate standards for office, industrial, multi-unit residential, retail, mixed-use, and gross areas. A team should cite the standard or contract it is using, not mix familiar terms from different systems.

Do not apply a rentable-area convention to a design program without explaining the translation. The BOMA office standard distinguishes occupant and rentable areas for office buildings. Those values answer a different question from whether a department received its programmed usable space.

Put the basis next to the schedule or link it directly. A reader should not need to search an old email to learn why two correct-looking totals disagree.

Why do target and modeled areas diverge?

They diverge because the model develops. An early program may describe assignable rooms while the plan must also accommodate walls, circulation, structure, services, and shared functions. A single-line diagram and a double-line plan are not measuring the same spatial condition.

Geometry can also reveal conflicts in the brief. A room group may fit as a sum of targets but fail once realistic proportions, doors, access, furniture, and adjacencies are considered. The variance is then evidence about the design problem, not merely an error to eliminate.

Scope changes create another class of variance. A client may add a function, combine spaces, or change a capacity. Record the approved change and its effect on both target and measured totals. Otherwise the design team appears to have missed a target that no longer applies.

Measurement errors remain possible. Overlapping boundaries, unclosed rooms, duplicated spaces, wrong units, or an outdated schedule can create false confidence. Check the model state and boundary logic before treating every variance as a design issue.

Finally, aggregation can hide offsetting problems. A large circulation surplus may be balanced by undersized rooms, leaving the gross total close to target. Review the components and the total together.

Our article Do Your Design Forms Match the Area? explores this tension between form and program in more detail.

Build an area schedule beside your model in Snaptrude.

How should an architectural area schedule show variance?

Use both an absolute difference and a percentage, but interpret them in context. A small percentage at building scale can still represent a major room or department issue. A large percentage on a tiny support space may have little effect on the whole project.

Field Purpose Review question Example status
Target area Preserves the agreed requirement Is this still the current brief? Confirmed
Measured area Reports the selected model boundary Does the basis match the target? Current model
Absolute variance Shows the magnitude of difference How much space changed? Investigate
Percentage variance Supports comparison across differently sized groups Is the relative change material? Accepted range
Measurement basis Defines inclusions and boundary rules Are we comparing like with like? Verified
Decision note Explains the change and owner Is this drift, correction, or approved scope? Client decision

Set review bands only when the project team has agreed what they mean. A generic color threshold can turn professional judgment into a false rule. Some spaces have strict functional minimums; others can absorb more variation. The schedule should surface exceptions, not decide them automatically.

Use notes sparingly but specifically. “Design development” explains little. “Core widened after stair review; department target unchanged” tells the next reviewer what happened and where to look.

Freeze a reviewed snapshot at major decisions. The working schedule may change continuously, but a dated snapshot lets the team compare the current model with the accepted basis. This is particularly helpful when several option branches exist.

How do you keep the area schedule connected to design decisions?

Review area while looking at the corresponding spaces. A schedule row without spatial context can identify a variance but cannot explain its design consequence. Conversely, an attractive plan without a program view can make lost area invisible.

Organize reviews around questions. Which department changed most? Which spaces are outside the agreed range? Did circulation grow because it improves wayfinding, or because the plan has not been resolved? Which variance depends on a client choice? Questions create a path from number to action.

Connect the schedule to adjacency and option review. If a team moves a department to improve a critical relationship, show the area effect. If one option has a better gross-to-net relationship, verify that it did not achieve efficiency by weakening the brief.

Snaptrude's Program Mode supports programming, area calculations, adjacency planning, and program edits. Schedules remain connected to the model as designers work. Those capabilities help teams inspect change, but they do not choose a measurement standard or approve a variance for the project.

The same principle applies to handoff. Snaptrude supports BIM modeling and Revit, Rhino, DWG, and IFC exports. The receiving team should verify the intended geometry, data, units, and schedule basis. File creation is not a substitute for acceptance.

For a complementary way to review spatial relationships, see AI Space Planning at Department Level.

When is an architectural area schedule ready for approval?

It is ready when the team understands the measurement basis, can trace targets to the current brief, and has resolved or assigned every material variance. The schedule does not need to show zero variance. It needs to show controlled variance.

Check that totals reconcile across levels. Room groups should roll into departments, departments into floors, and floors into the building using consistent rules. If an item appears in more than one group, make that treatment explicit.

Check that the schedule and geometry refer to the same revision. An updated plan with an earlier export can be more dangerous than an obviously incomplete table because it appears authoritative. Put revision information where reviewers can see it.

Ask whether someone new to the decision can understand each exception. If a variance note only makes sense to the person who wrote it, the record is too thin. Name the cause, the accepted response, and the owner of remaining work.

Approval should also state its purpose. A schedule accepted for schematic planning may not satisfy a lease measurement, cost plan, regulatory submission, or facilities record. Carry the measurement basis and limitations into the next use.

Frequently Asked Questions

Q: What is an architectural area schedule?

A: An architectural area schedule compares program requirements with measured model areas. It commonly records names or identifiers, targets, current values, variances, statuses, and decision notes at several levels. Its value comes from a clear measurement basis and traceable changes. It should help reviewers understand why an area differs, not simply display a total.

Q: What is the difference between net and gross area?

A: Net area generally describes usable or assignable space, while gross area includes additional building components. Exact definitions vary by standard and purpose. Circulation, walls, shafts, services, and shared facilities may be treated differently. Cite the governing measurement method and list key inclusions so reviewers do not compare values calculated under incompatible rules.

Q: Should an area schedule always match the program exactly?

A: No. Design development, geometry, systems, circulation, and approved scope changes can create legitimate differences. The goal is controlled variance, not automatic equality. Review the size, cause, consequence, and decision owner for each material difference. An unexplained match can be less trustworthy than a documented variance that the team has consciously accepted.

Q: How often should architects update the area schedule?

A: Update it whenever a design or program change could affect the decision being reviewed. Continuous model-linked values are useful, but teams should also preserve dated snapshots at important approvals. Verify that the schedule and geometry share the same revision before every formal review, option comparison, handoff, or submission that relies on area.

Q: Can Snaptrude create an architectural area schedule?

A: Snaptrude supports programming, area calculations, adjacency planning, program edits, and schedules. Designers can inspect those values while changing the model. The project team must still choose the correct measurement basis, validate inputs, explain material variances, and obtain required approvals. Software can keep information connected without deciding what the contract or standard requires.

Q: How should area data leave Snaptrude?

A: Identify the reviewed model state, units, boundary rules, program revision, and exceptions before handoff. Snaptrude supports Revit, Rhino, DWG, and IFC export paths, but the receiving workflow should be tested for the project's needs. Confirm that the geometry and information remain usable and that the schedule's meaning is not lost during exchange.

Try Snaptrude for a model-linked program and area workflow.

Join us to stay updated and be a part of our story!

Thank you! We'll keep you up to date.
Oops! Something went wrong while submitting the form.
Snaptrude Logo

Design better buildings together

Start designing with Snaptrude - faster, BIM-ready, and built for real-time collaboration.

Try Snaptrude
